A construction quality audit helps a project team confirm that its quality management system is actually working—not simply that procedures, forms and registers exist.
A construction audit examines whether the project’s processes comply with the contract, Project Quality Plan, company procedures, specifications and other applicable requirements. More importantly, it should determine whether those processes are properly implemented and effective.
That distinction matters.
A project can have an impressive library of procedures, Inspection and Test Plans, method statements and registers and still experience repeated defects, missed inspections, uncontrolled drawings and incomplete handover records.
A good construction quality audit looks beyond the paperwork. It follows the process from the documented requirement to what is actually happening on site and then into the records that provide evidence of compliance.
This guide explains:
- What a construction quality audit is
- The difference between an audit and an inspection
- The seven main types of construction audit
- How to plan and conduct an audit
- What to include in a construction audit checklist
- How to classify audit findings
- What a construction audit report should contain
- How to follow up and close audit findings
What is a construction quality audit?
A construction quality audit is a systematic review of a project, process, contractor, subcontractor or supplier to determine whether established quality requirements are being followed and whether the controls are effective.
Depending on its scope, an audit may examine:
- The Project Quality Plan
- Quality objectives and responsibilities
- Design and document control
- Procurement and supplier approval
- Material submissions and approvals
- Method statements
- Inspection and Test Plans
- Site inspections and testing
- Measuring-equipment calibration
- Nonconformities and corrective actions
- Subcontractor management
- Quality records and handover documentation
- Internal audits and management reviews
- Client and contractual requirements

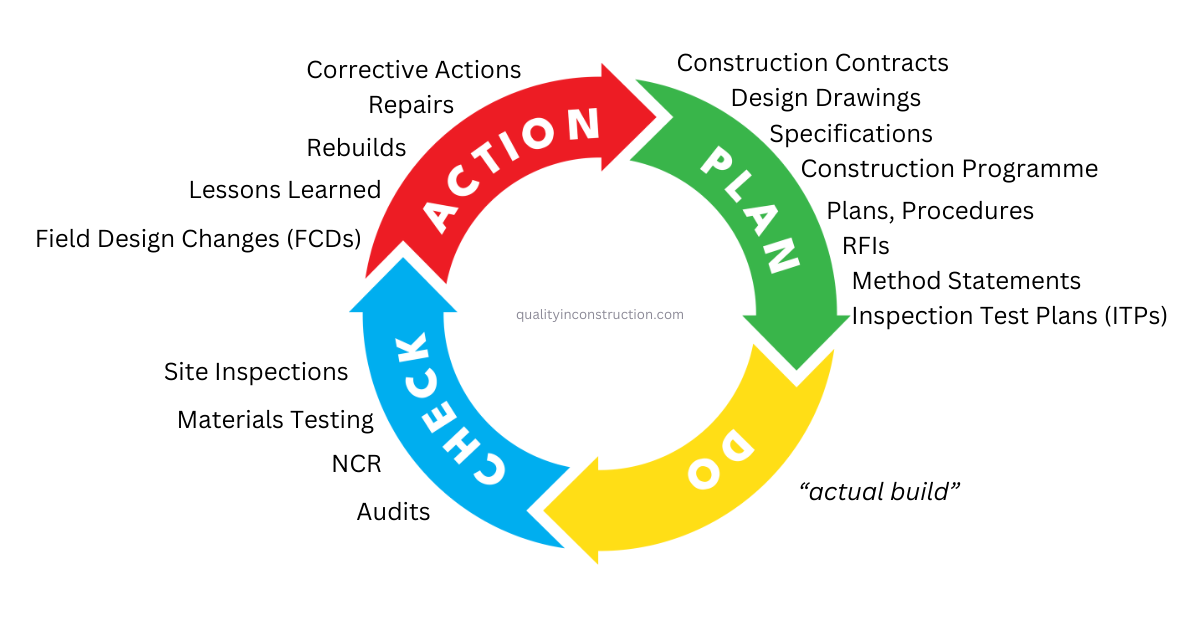

Construction internal audits are an important part of the Check stage of the Plan–Do–Check–Act cycle.
The project establishes its controls during the Plan stage, implements them during Do, evaluates their performance during Check, and uses the results to make improvements during Act.
An audit is therefore not just a compliance exercise. It is one of the main tools available to management for understanding whether the project’s quality arrangements are producing the intended results.
ISO 9001 also requires organisations to conduct internal audits at planned intervals. These audits provide information about whether the quality management system conforms to the organisation’s own requirements and the requirements of the standard, and whether it is effectively implemented and maintained.
For a detailed explanation of the standard’s requirements, see my ISO 9001 internal audit guide and checklist. Construction companies can also read my practical guide to ISO 9001 for construction companies.
Construction quality audit versus site inspection
Construction audits and inspections are closely related, but they are not the same thing.
A site inspection normally examines a particular item of work, material or activity. For example, an inspector may check reinforcement before concrete is poured or inspect a waterproofing installation before it is covered.
An audit examines the system or process surrounding that work.
For example, an audit of concrete works might check:
- Whether an approved method statement is available
- Whether the correct drawing revision is being used
- Whether the concrete ITP identifies the required inspections
- Whether hold and witness points were observed
- Whether approved materials were used
- Whether testing equipment was calibrated
- Whether concrete test results were reviewed
- Whether rejected results were investigated
- Whether records can be traced to the relevant concrete pour
An inspection asks:
Does this particular item of work meet the requirement?
An audit asks:
Is the process consistently controlling the work and producing reliable evidence of compliance?
A quality walk, surveillance or mini audit may include elements of both. The important thing is to define the purpose and scope before starting.
Why construction quality audits are important
Construction projects involve many organisations working at the same time: clients, designers, consultants, main contractors, subcontractors, suppliers, laboratories and specialist inspectors.
Even when the project has good procedures, failures can occur between these interfaces.
A subcontractor may work to an outdated drawing. An inspection may be completed but not recorded. A material may arrive without the correct certification. A test result may fail without triggering an NCR. A design change may be approved but not communicated to the site team.
A well-planned construction audit can identify these weaknesses before they become repeated defects, expensive rework, delays or handover problems.
Construction audits can help a project:
- Verify compliance with contractual requirements
- Confirm that the Project Quality Plan is being implemented
- Identify weaknesses in processes and interfaces
- Detect recurring or systemic problems
- Evaluate subcontractor and supplier controls
- Confirm that inspections and tests are properly completed
- Check the traceability of materials and records
- Determine whether corrective actions are effective
- Identify good practices that can be shared
- Provide management with reliable information
- Support continual improvement
Audits should not be used as punishment or as a way of winning commercial arguments. That approach creates defensive behaviour and encourages people to hide problems.
The most valuable audits help the project understand risk, improve its processes and prevent the same problems from happening repeatedly. They form part of the wider system described in my Construction Quality Management hub.

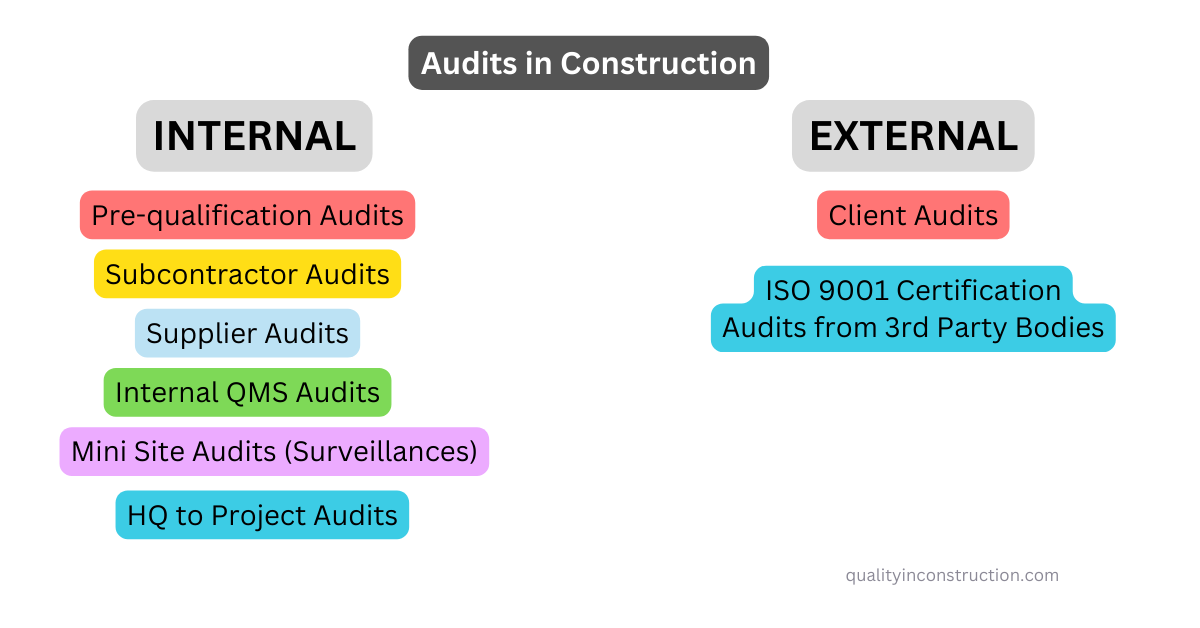

The seven types of construction audit
The auditor, auditee, scope and purpose will change depending on the type of construction audit being performed.
The following seven audit types are commonly encountered on construction projects.
1. Prequalification or pre-selection audits
A prequalification audit is conducted before a contract is awarded to determine whether a prospective subcontractor, supplier, designer or specialist organisation has the capability to meet the project’s requirements.
The audit may be performed by the main contractor, client or consultant.
A prequalification audit should not be limited to asking whether the organisation has an ISO 9001 certificate. Certification can provide useful assurance, but it does not automatically demonstrate that the organisation has the resources, experience or project-specific controls required for the proposed work.
The audit may review:
- Relevant project experience
- Organisation and responsibilities
- Competence and qualifications
- Quality-management certification
- Procedures and work instructions
- Inspection and testing capabilities
- Control of suppliers and sub-tier contractors
- Previous NCRs or client complaints
- Equipment and calibration
- Production capacity
- Material traceability
- Document and record control
- Previous project performance
Following a successful assessment, the organisation may be added to an approved supplier list or allowed to continue into the tendering process.
Any weaknesses should be recorded, assessed and resolved before work begins.
2. Third-party certification audits
Third-party audits are performed by an independent certification body to determine whether a construction company’s management system conforms to a recognised standard such as ISO 9001.
These audits may also cover ISO 14001 for environmental management and ISO 45001 for occupational health and safety. Organisations operating these standards together may benefit from an integrated management system.
Certification is often requested by clients during prequalification or required by the contract.
A certification audit may examine both corporate processes and their implementation on selected construction projects. The certification body will normally conduct periodic surveillance audits and a more extensive recertification audit at the end of the certification cycle.
The purpose is not to approve individual construction activities. It is to evaluate the organisation’s management system within the defined certification scope.
3. Project internal construction audits
Project internal audits are usually conducted by the project’s Quality or QA/QC team.
Their purpose is to determine whether the processes established for the project are being followed and whether they are effective.
The audit programme should reflect the project’s activities and risks. Instead of auditing every department with the same frequency, the Quality Manager should give greater attention to processes that:
- Have a high impact on quality
- Are complex or difficult to inspect later
- Have produced recurring NCRs
- Involve new subcontractors or suppliers
- Have recently changed
- Are approaching critical stages
- Have performed poorly during previous audits
- Affect handover or statutory approval
A project internal audit may focus on one process, such as document control, or follow an activity across several departments, such as the complete process for concrete works from design approval and procurement through to placement, testing and record completion.
4. Internal audits from the parent company
The corporate Quality Department of a contractor may audit one of its projects to confirm that corporate procedures and governance requirements are being implemented.
These audits also provide senior management with an independent view of project performance.
Parent-company audits are common in large construction organisations and joint ventures. In a joint venture, each partner may need assurance that the project is managing quality consistently with agreed procedures and contractual commitments.
A corporate audit might examine:
- Implementation of company procedures
- Project quality risks
- Client requirements
- Performance against quality objectives
- NCR trends
- Subcontractor management
- Adequacy of project resources
- Internal-audit performance
- Handover readiness
- Lessons learned
The project should treat these audits as an opportunity to obtain an outside perspective—not as an inspection from head office that must be survived.
5. Client audits
Clients and their representatives may audit a contractor to verify that contractual quality-management requirements are being implemented.
The contractor is normally represented by the Project Manager, Quality Manager and relevant process owners. Depending on the scope, subcontractors, designers and suppliers may also participate.
A client audit may review:
- Compliance with the Project Quality Plan
- Contractually required procedures
- Quality staffing and responsibilities
- Design coordination
- Procurement controls
- Material approvals
- Inspection and testing
- NCR management
- Quality reporting
- Handover documentation
- Previous audit findings
Construction is unusual because the customer can observe and audit the management of the product while that product is being created.
The audit arrangements—including access, notice periods, reporting and follow-up—may be defined in the contract. Planned audit dates are often included in an audit schedule submitted to the client.
6. Mini project audits and quality surveillances
Mini audits, surveillances, quality tours and works audits are shorter and more focused than a full system audit.
They are normally conducted by the project Quality Department to confirm that an approved process is being followed where the work is taking place.
For example, a surveillance of waterproofing work could check:
- Availability of the approved method statement
- Use of the correct drawing revision
- Material approval and shelf life
- Substrate preparation
- Environmental conditions
- Installer competence
- Required inspections and hold points
- Protection of completed work
- Completion of quality records
These short audits can be extremely effective because they connect documented requirements directly to site activities.
However, they should not replace the formal internal-audit programme. A surveillance provides a focused snapshot; a full audit examines the wider process, interfaces and effectiveness.
7. Other or unplanned construction audits
Management may request an unplanned or special audit following:
- A major NCR
- Repeated defects
- A serious client complaint
- Failure of a material or system
- A significant change in the project
- Poor subcontractor performance
- An adverse trend in quality data
- A breakdown in an important process
- Suspected falsification or loss of records
The purpose should be clearly defined. In many cases, the audit will support an investigation by examining how the relevant process was planned, implemented and monitored.
An audit should not replace a proper root-cause investigation, but it may reveal wider weaknesses that contributed to the problem. My guide to nonconformity and corrective action explains how to investigate causes and prevent recurrence.

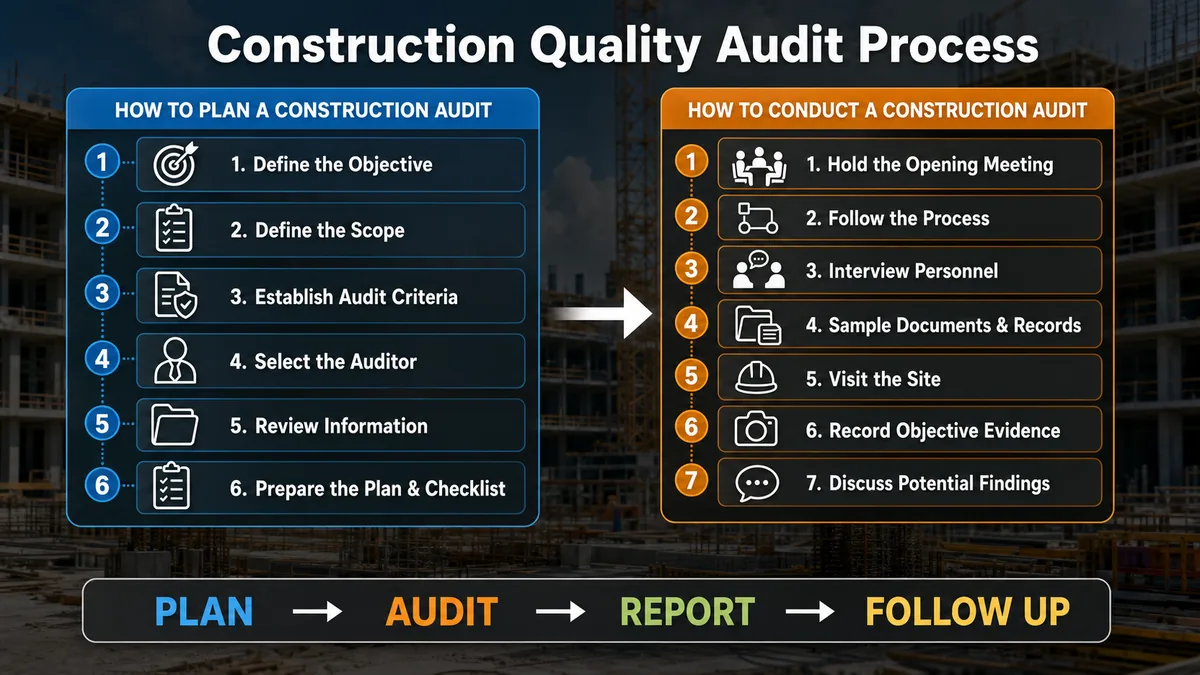

How to plan a construction quality audit
A useful audit begins well before the auditor arrives on site.
Poorly planned audits tend to become tours of available documents, driven by whichever person happens to be in the room. Good planning allows the auditor to follow the important risks, activities and interfaces.
1. Define the audit objective
The objective explains why the audit is being conducted.
Examples include:
- Verify implementation of the Project Quality Plan
- Evaluate control of concrete construction
- Assess the capability of a proposed supplier
- Confirm the effectiveness of the NCR process
- Review handover readiness
- Verify closure of previous audit findings
A vague objective such as “audit the Quality Department” is rarely helpful.
2. Define the scope
The scope establishes the boundaries of the audit.
It might identify:
- The project, location or facility
- The process or department
- The subcontractor or supplier
- The construction activity
- The period being reviewed
- Any exclusions
For example:
Review the control of structural concrete works undertaken between January and March, including approved materials, ITP implementation, inspection records, concrete testing, NCRs and traceability.
3. Establish the audit criteria
Audit criteria are the requirements against which evidence will be evaluated.
Depending on the audit, they may include:
- Contract requirements
- Project specifications
- Approved drawings
- The Project Quality Plan
- Company procedures
- Method statements
- Inspection and Test Plans
- Applicable legislation
- Codes and standards
- Client procedures
- ISO 9001 requirements
An auditor cannot raise a valid nonconformity simply because something is not being done in their preferred way. The finding must be connected to an applicable requirement.
4. Select a competent and impartial auditor
The auditor should understand:
- Audit principles and techniques
- Construction quality-management processes
- The activity being audited
- How to collect and evaluate evidence
- How to communicate with different members of the project team
- How to write clear, factual findings
An internal auditor does not always need to be completely separate from the project, but they should be objective and should not audit their own work wherever practicable.
Technical expertise can be provided by another member of the audit team when required.
5. Review relevant information
Before the audit, review information such as:
- Previous audit reports
- Open audit findings
- NCR trends
- Client complaints
- Construction quality metrics and KPIs
- Inspection and testing results
- Process changes
- Relevant procedures
- Organisational responsibilities
- Current construction activities
This helps the auditor identify areas that require deeper sampling.
6. Prepare the audit plan and checklist
The audit plan should communicate:
- Objective
- Scope
- Criteria
- Date and location
- Audit team
- Auditee representatives
- Processes and activities to be reviewed
- Timetable
- Opening and closing meetings
- Reporting arrangements
A checklist helps the auditor prepare, but it should not become a script.
The auditor must be willing to follow the evidence. If one answer reveals a significant weakness, it may be more valuable to investigate that issue than to rush through another twenty generic questions.
How to conduct a construction quality audit
1. Hold an opening meeting
The opening meeting should confirm:
- The audit objective, scope and criteria
- The proposed programme
- Relevant safety and site-access requirements
- Key contacts and availability
- Communication arrangements
- Reporting and classification of findings
- The expected time of the closing meeting
The auditor should explain that the audit will use sampling. An audit cannot examine every document, person, inspection and item of work.
2. Follow the process
A strong construction audit follows a process rather than reviewing documents in isolation.
For example, when auditing material control, the auditor might:
- Select a material already incorporated into the works.
- Identify the relevant drawing and specification.
- Confirm that the material was technically approved.
- Check the purchase order.
- Review the supplier’s certification.
- Examine delivery and receiving records.
- Confirm storage and preservation.
- Review the relevant inspection request.
- Confirm traceability to the installed location.
- Check whether the completed record is included in the handover file.
This approach reveals whether the entire process works.
3. Interview personnel
Ask open questions such as:
- “Can you show me how this process works?”
- “How do you know which drawing revision to use?”
- “What happens when a test result fails?”
- “Who approves this material before it is ordered?”
- “How do you know that this inspection has been accepted?”
- “Show me the most recent example.”
Do not rely entirely on verbal explanations. Follow the answer to the relevant record, activity or physical evidence.
4. Sample documents and records
Audit sampling should be purposeful.
Include examples from:
- Different subcontractors
- Different areas of the project
- Recent and older activities
- Accepted and rejected work
- Different inspectors
- High-risk or concealed work
- Previous problem areas
One perfect record selected by the auditee does not demonstrate that the process is consistently effective.
5. Visit the site
A construction quality audit should not remain in the meeting room.
On site, compare actual conditions with:
- Approved drawings
- Method statements
- Inspection and Test Plans
- Material approvals
- Required workmanship standards
- Inspection status
- Storage requirements
- Identification and traceability requirements
Talk to supervisors, engineers, inspectors and operatives. Their understanding often gives a better indication of implementation than the procedure itself.
6. Record objective evidence
Audit conclusions should be based on evidence that can be verified.
Objective evidence might include:
- Document titles and revision numbers
- Inspection request references
- Test-report numbers
- NCR references
- Material certificates
- Photographs
- Locations
- Dates
- Names or roles of relevant personnel
- Observations made during the site visit
Avoid vague statements such as “Document control is poor.”
A useful finding identifies the sample, the applicable requirement and what was actually found.
7. Discuss potential findings
Where practicable, discuss a potential finding with the responsible person before the closing meeting.
This allows factual misunderstandings to be corrected and gives the auditee an opportunity to provide additional evidence.
It does not mean negotiating the finding away. The auditor remains responsible for evaluating the evidence objectively.
Construction quality audit checklist
Every checklist should be adapted to the project, scope and risks. The following questions provide a practical starting point.
Project Quality Plan and responsibilities
- Is there an approved Project Quality Plan?
- Are quality responsibilities clearly assigned?
- Are project quality objectives defined and monitored?
- Are sufficient competent quality personnel available?
- Are changes to the project organisation controlled?
Drawings and document control
- Are current approved drawings available where the work is performed?
- Are obsolete drawings removed or clearly identified?
- Are RFIs, technical queries and design clarifications controlled?
- Are document revisions communicated to affected personnel?
- Can completed records be retrieved easily?
Method statements and ITPs
- Are approved method statements available before work starts?
- Do the method statements reflect the actual construction process?
- Are activity-specific ITPs approved?
- Are hold, witness and review points clearly identified?
- Are acceptance criteria specific and measurable?
- Are the required inspection records being completed?
Materials and suppliers
- Are suppliers and subcontractors properly evaluated?
- Are materials approved before purchase or installation?
- Are delivery documents and certificates reviewed?
- Are materials correctly identified, stored and preserved?
- Is traceability maintained where required?
- Are nonconforming materials segregated and controlled?
Inspections and testing
- Are inspections requested at the correct stage?
- Is work protected from being covered before acceptance?
- Are inspectors competent for the activities they inspect?
- Are test results reviewed against the specified criteria?
- Do failed tests trigger appropriate action?
- Are inspection and testing records complete and traceable?
Measuring and testing equipment
- Is equipment uniquely identified?
- Is its calibration status evident?
- Are calibration certificates current?
- Is equipment protected from damage or deterioration?
- Is the impact assessed when equipment is found outside calibration?
NCRs and corrective actions
- Are nonconformities identified and recorded consistently?
- Are immediate corrections distinguished from corrective actions?
- Are root causes investigated where appropriate?
- Are responsibilities and deadlines assigned?
- Is the effectiveness of corrective action verified?
- Are repeated NCRs analysed for trends?
For more practical guidance, see how to close an NCR in construction.
Competence and awareness
- Are competence requirements defined?
- Are qualifications, training and authorisations recorded?
- Do personnel understand the requirements affecting their work?
- Are toolbox talks and briefings relevant to current quality risks?
- Is competence evaluated rather than assumed from attendance alone?
Handover and quality records
- Are handover requirements defined?
- Is responsibility assigned for compiling records?
- Are test certificates, inspections, approvals and as-built information complete?
- Are missing records identified early?
- Is handover readiness monitored throughout the project?
Construction audit findings
The output of a construction audit normally includes some combination of:
- Nonconformities
- Observations
- Opportunities for improvement
- Positive practices
The exact terminology and classification criteria should be defined in the organisation’s audit procedure.
Nonconformity
A nonconformity is the failure to meet a requirement.
A well-written nonconformity should contain three elements:
- The requirement: What should have happened?
- The objective evidence: What did the auditor examine or observe?
- The statement of nonconformity: How was the requirement not fulfilled?
For example:
The approved concrete ITP requires concrete test results to be reviewed and accepted by the responsible engineer. For pours C-104, C-108 and C-111, test reports were available, but no evidence of technical review or acceptance could be demonstrated.
The classification of major and minor findings varies between organisations.
Generally, a major finding indicates a systemic breakdown, a serious risk or the complete absence of an important required process. A minor finding is normally a limited lapse that does not demonstrate the complete failure of the system.
Classification should follow the applicable procedure—not the auditor’s personal preference.
Observation
An observation identifies a condition that is not currently demonstrated to be a nonconformity but may deserve attention.
Observations should not be used to avoid raising a valid NCR. Equally, auditors should not turn personal suggestions into mandatory requirements.
Opportunity for improvement
An opportunity for improvement identifies a possible way to make a process more effective, efficient or reliable.
The auditee is not normally required to adopt the auditor’s suggested solution. Management remains responsible for deciding how the process should be improved.
Positive practice
A useful audit should also recognise effective controls and good practices.
Highlighting good performance helps the organisation understand what is working and whether it could be applied elsewhere.
The construction audit closing meeting
The closing meeting should present the audit conclusions clearly and without surprises.
Discuss:
- The scope and activities completed
- The sampling approach
- Positive practices
- Nonconformities
- Observations and improvement opportunities
- Any limitations encountered
- Reporting arrangements
- Corrective-action deadlines
- Follow-up requirements
The auditor should present findings calmly and factually. The meeting is not a courtroom, and an audit should never become a contest between the auditor and the project team.
Disagreement may occur, especially where contractual requirements are ambiguous. The auditor should listen to relevant evidence, explain the basis of the finding and use the organisation’s escalation process if agreement cannot be reached.
What should a construction audit report include?
The construction audit report is the formal record of the audit and may support important project or commercial decisions. It must therefore be accurate, balanced and carefully worded.
A practical construction audit report should include:
- Project and organisation
- Audit title and reference number
- Audit date and location
- Audit objective
- Audit scope
- Audit criteria
- Auditor or audit team
- Auditee representatives
- People interviewed
- Activities and locations visited
- Documents and records sampled
- Executive summary
- Positive practices
- Nonconformities
- Observations
- Opportunities for improvement
- Overall audit conclusion
- Required corrective actions
- Responsible persons
- Target completion dates
- Follow-up and closure arrangements
Audit findings must be supported by factual evidence. Avoid emotional language, assumptions and accusations.
This is especially important during audits of subcontractors and suppliers because audit reports may influence approvals, payments, future work or commercial relationships.
The auditor must still report genuine failures clearly. Careful wording does not mean weakening the finding—it means making it accurate and defensible.
Corrective action and audit follow-up
Issuing the report is not the end of the audit.
For each nonconformity, the responsible organisation should normally:
- Correct or contain the immediate problem.
- Assess the extent and consequences of the issue.
- Determine the root cause where appropriate.
- Define corrective action.
- Assign responsibility.
- Agree a completion date.
- Implement the action.
- Provide evidence.
- Verify effectiveness.
- Close the finding when satisfied.
Simply submitting a revised procedure is not always sufficient. The auditor should verify that the action has been implemented and that it addresses the cause of the problem.
For significant or systemic findings, verification may require a follow-up audit.
Repeated findings should be escalated. They may indicate that previous corrective actions addressed the symptom rather than the underlying cause.
Audit results, recurring findings and overdue corrective actions should also be considered during management review meetings and when deciding how to assess and monitor construction quality.
Common construction audit mistakes
Auditing only the Quality Department
Quality personnel may coordinate the system, but responsibility for quality belongs across the project.
An effective audit should include engineering, procurement, construction, commercial management, document control, subcontractors and other relevant functions.
Treating the checklist as the audit
A checklist supports the auditor’s preparation. It does not replace professional judgement, process-based questioning or examination of evidence.
Focusing only on paperwork
Good records matter, but an audit should verify that the documented process reflects what is happening on site.
Raising findings without a requirement
A preference is not a requirement. Every nonconformity should be connected to established audit criteria.
Accepting one perfect example
Auditing is based on sampling, but the sample should be representative. Ask for recent, older, successful and problematic examples.
Using audits as punishment
If audits are used to embarrass people or settle disagreements, the project will learn to conceal problems instead of addressing them.
Closing findings without checking effectiveness
Receiving a document or email does not necessarily prove that corrective action worked. Closure should be based on suitable evidence.
A practical approach to construction auditing
Auditors must remain objective and consistent, but construction also requires proportionate judgement.
Projects operate in changing conditions. Requirements can be complicated, interfaces can be unclear, and some contractual wording can be ambiguous. Auditors should consider risk and significance while remaining faithful to the applicable requirements.
That does not mean ignoring nonconformities. It means concentrating on issues that affect the ability of the project to meet its requirements rather than wasting time on arguments that add no value.
I remember auditing a concrete batching plant in the Middle East, located in the middle of the scorching desert.
From a conventional quality-management perspective, the plant was impressive. The required documentation was available, and many of the controls were properly implemented.
However, the people operating the plant were living in terrible conditions in cabins beside the aggregates.
The audit was supposedly concerned with the quality of concrete, but it was impossible to ignore the quality of life of the people producing it.
That experience stayed with me. Auditors need procedures, criteria and evidence, but they also need awareness, judgement and common sense.
Frequently asked questions
What is a construction quality audit?
A construction quality audit is a systematic review used to determine whether a project, contractor, process or activity complies with established quality requirements and whether its controls are effectively implemented.
How is a construction audit different from an inspection?
An inspection checks a particular material, activity or item of work. An audit evaluates the process used to control that work, including responsibilities, documents, implementation and records.
How often should construction projects be audited?
Audit frequency should be based on project risk, contractual requirements, process importance, previous performance, significant changes, NCR trends and the results of earlier audits. High-risk or poorly performing processes should normally receive more attention.
Who should conduct a construction internal audit?
The audit should be conducted by a competent person who understands auditing and the relevant construction processes. The auditor should be objective and should avoid auditing their own work wherever practicable.
What should be included in a construction audit checklist?
The checklist should reflect the audit scope and may include the Project Quality Plan, responsibilities, drawings, document control, materials, method statements, ITPs, inspections, testing, calibration, NCRs, competence, subcontractor control and handover records.
What is included in a construction audit report?
The report should identify the objective, scope, criteria, audit team, people interviewed, evidence sampled, positive practices, nonconformities, observations, overall conclusions and the arrangements for corrective action and follow-up.
Can an audit raise an NCR?
Yes. When objective evidence demonstrates that a specified requirement has not been fulfilled, the auditor can raise a nonconformity. The finding should clearly identify both the requirement and the supporting evidence.
Conclusion
Construction quality audits are most valuable when they test whether processes work in practice.
They should connect procedures with site activities, inspect representative evidence, identify genuine weaknesses and provide management with useful conclusions.
A strong construction audit programme does more than satisfy ISO 9001 or contractual requirements. It helps projects detect problems earlier, improve subcontractor performance, strengthen quality records, reduce repeated failures and prepare properly for handover.
The seven types of construction audit described in this guide serve different purposes, but the principles remain the same: plan the audit carefully, follow the process, collect objective evidence, report findings clearly and verify that corrective actions are effective.
Used properly, audits are not punishment and they are not paperwork exercises. They are practical management tools for making construction projects work better.
